| Clearing of the land.
This involved over a
month of cutting brush and trees with many bonfires to clear
the property. We then had to tear down the old barn
which was in poor shape and blocking the view. Finally
we needed to the old 70 foot mobile home removed. |
Background Info
After selling our boat we
decided we wanted to settle down in the mountains of western
NC.
We chose Asheville because of the weather, beauty of the
mountains, great music and great food scene.
James looked at over a 100 properties. We wanted one
with a view, power, septic, and well in place.
We found a great property just outside Asheville.
Small lot (1 acre) but is sided by a horse farm which gives
the property great privacy.
House Plans
Remembering the nightmare
for framing the first house we lived -
Click Here -
we wanted to keep the design a simple rectangle, 24x40 with
cathedral ceilings and open floor plan with interior walls
only being 7' high. With 12' peak for ceiling this
gives the appearance on one large room.
Here is
floor plan with decks

With my 30 plus years in the
weatherization and building science field I wanted to see if
I could build a zero heat home. To do this I worked
with John Meeks at AppleBlossoms Energy on designing our
wall, ceilings, and floors for dense pack cellulose.
We have 40 plus R-values in walls,
ceiling, and floor. Double wall construction to
minimize thermal breaks and ridged insulation on the
ceilings to minimize thermal breaks through rafters. We are
currently at 140 CFM's at 50 Pa on the blower door reading
and shooting for 93 CFM @ 50Pa which translates to .6 ACH @
50Pa.
Our HERS rating comes in at 38 and
our Manual J calculation is under 10,000 Btuh
I am not spending the money to have
the house certified as a Passavhaus but think we will come
close the German standard for a Passavhaus.
Click Here for what makes a house a Passavhaus
We are already well below the
Energy Star standard.
If all goes well internal heat
gains from lights, appliances, and body heat should supply
our heat load for much of the winter.
Our ventilation will be done with
an HRV (Heat Recovery Ventilation) system with the intake
air being preheated with a solar collector. We will
also be installing a solar hot water system
|
|

May 2011 - Mobile home being picked up a room at
a time and placed in large truck. This equipment was
able to roll the frame and axle up into a ball and dumped
into the truck. In about 4 hours the whole mess was
gone |

Old barn torn down and wood salvaged
for greenhouse and chicken coup |
|
Start of
Construction - Late July 2011

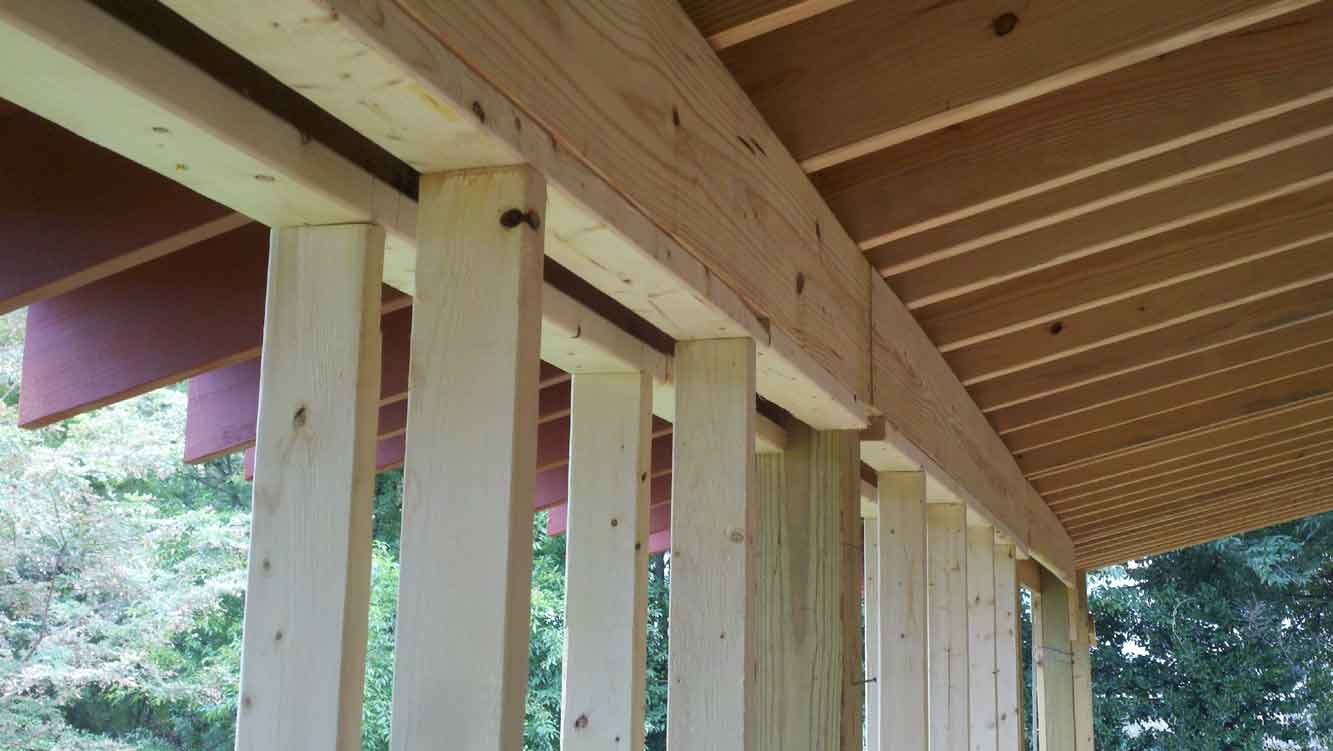

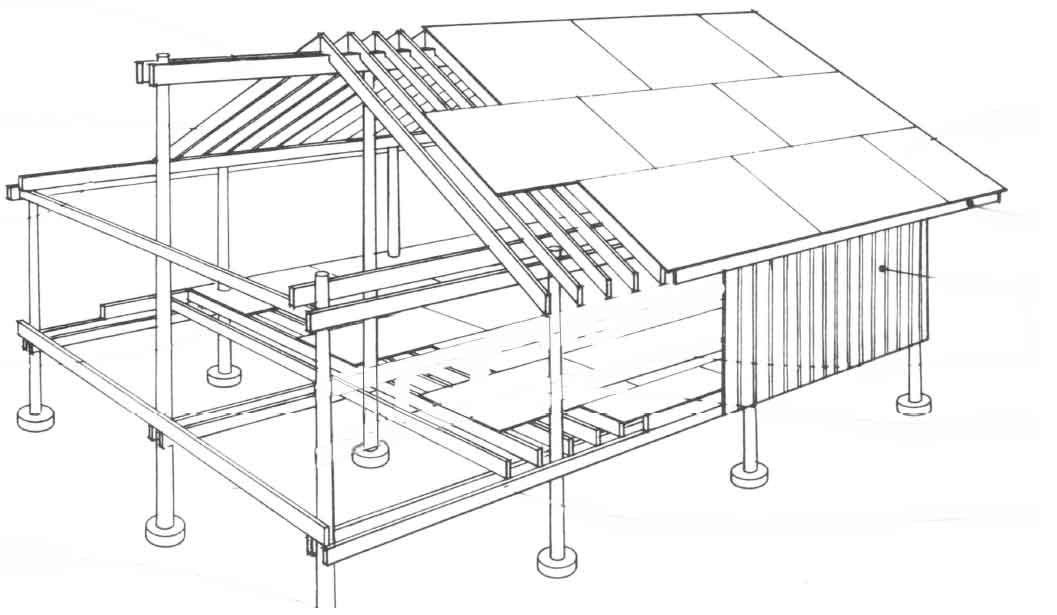

Framing Detail Used, click for image
 |
|

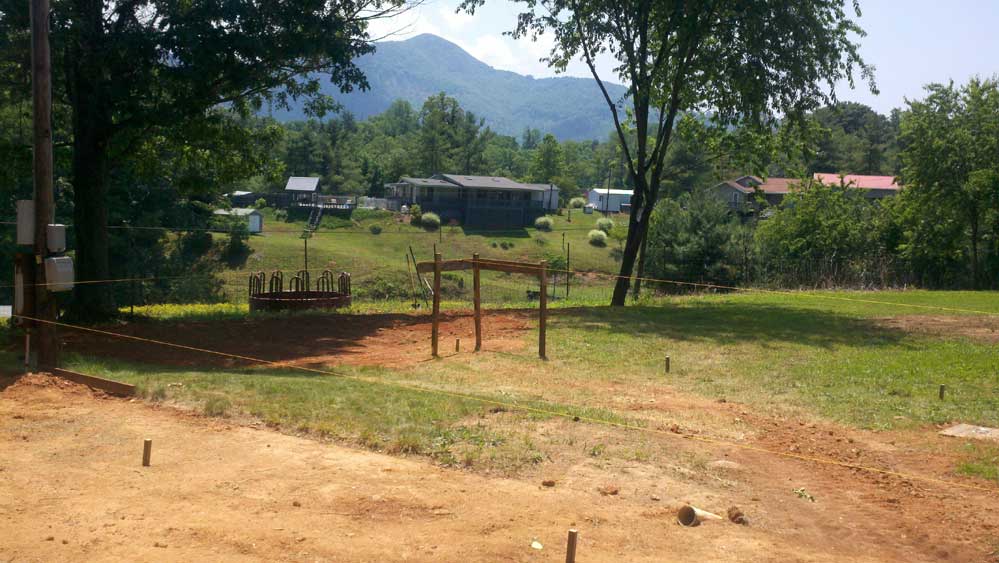

5/27/11 - Laying out the stakes to begin
digging of holes for poles
|

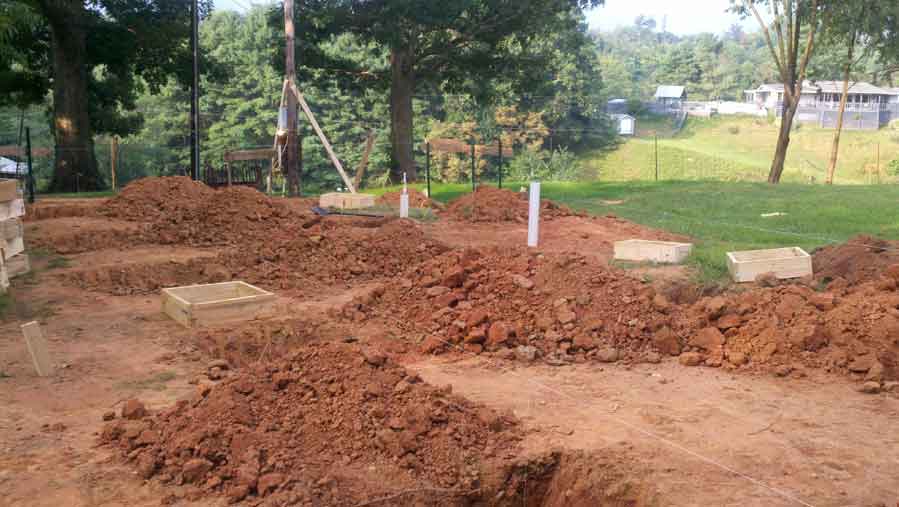

7/21/11 - Digging 17 holes for the pole footers,
we then built frames and mixed the concrete for the pads -
Total cost for our foundation - under $700 |
|

7/22/11 -

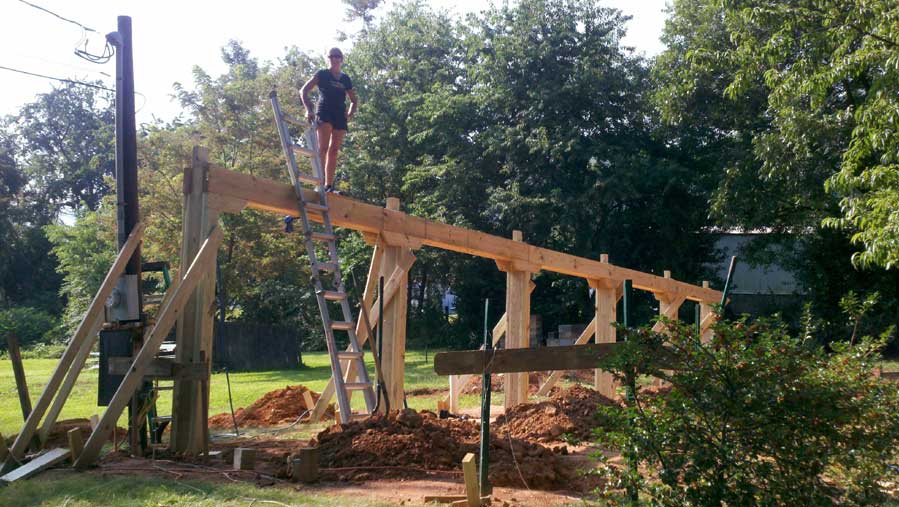

1st Pole in the air, very hot day but we had the first piece
of lumber
vertical, we had a celebration that evening, Second Pic is 5
centers poles up. |

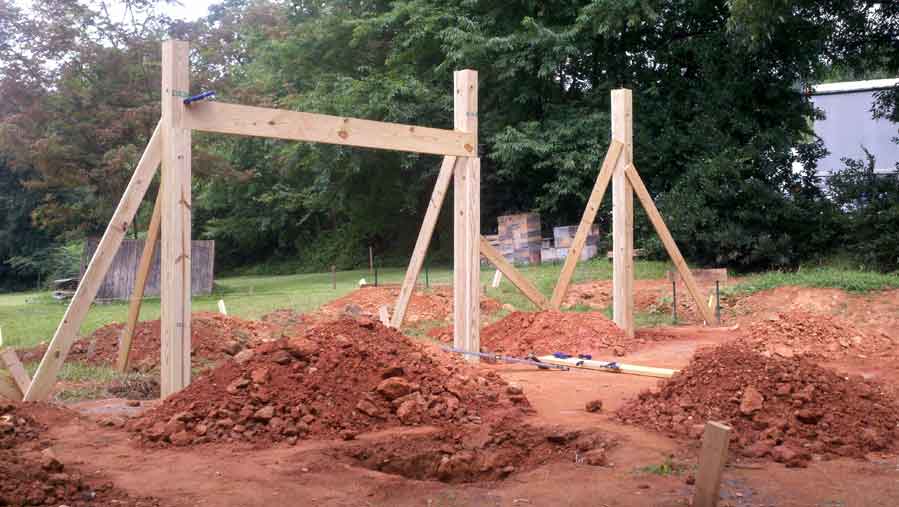

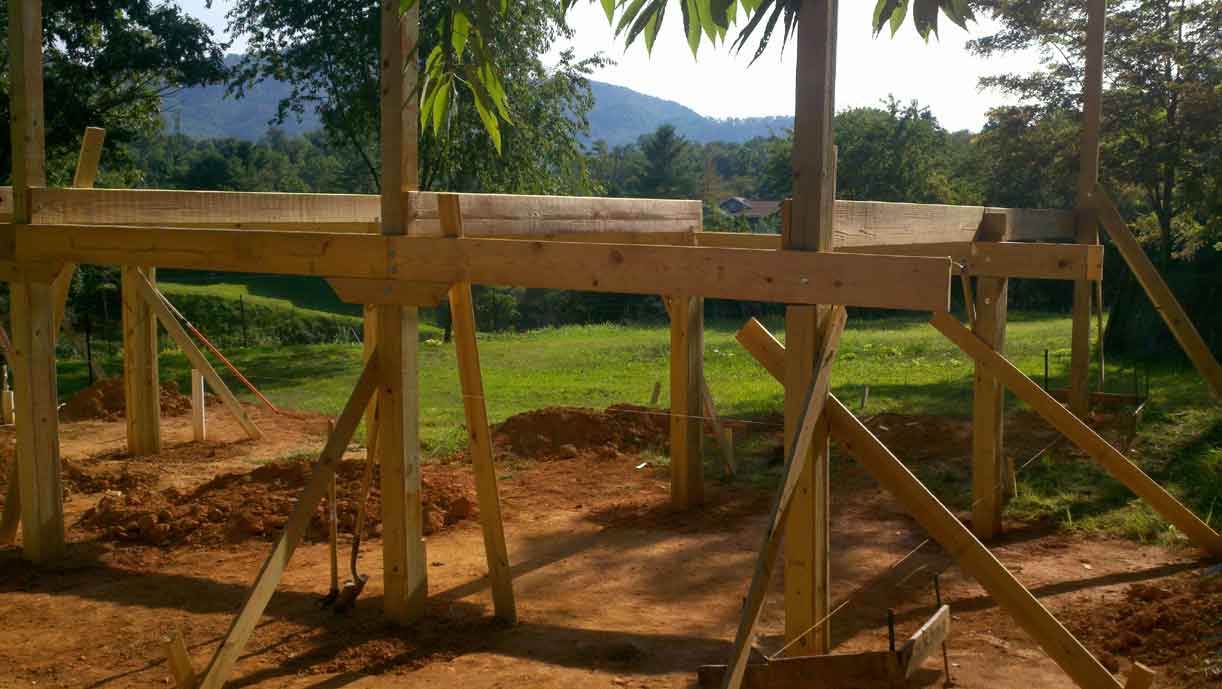

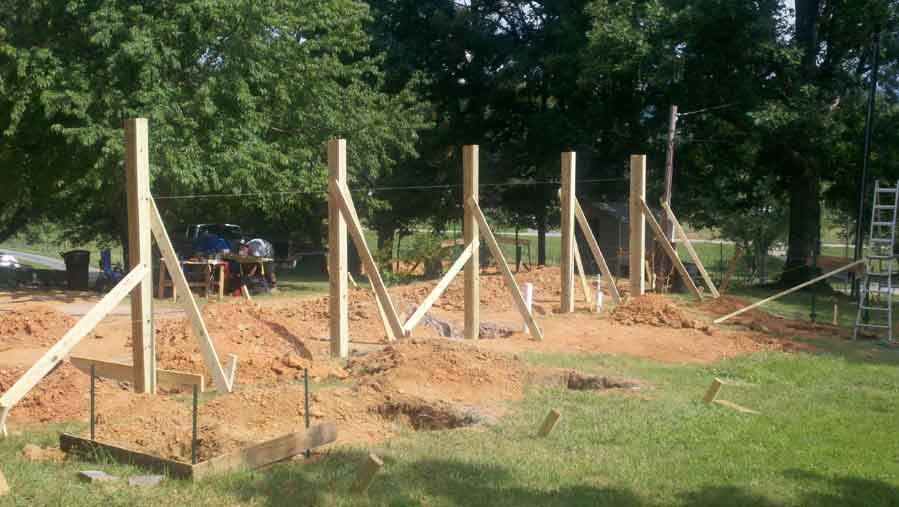

Center poles up with First Girt
support in place. Center poles only come up to floor
level where we will add another 12' pole. We could not
get 26' poles for center poles of house, 2nd Pic - finally
something to stand on in the air |
|

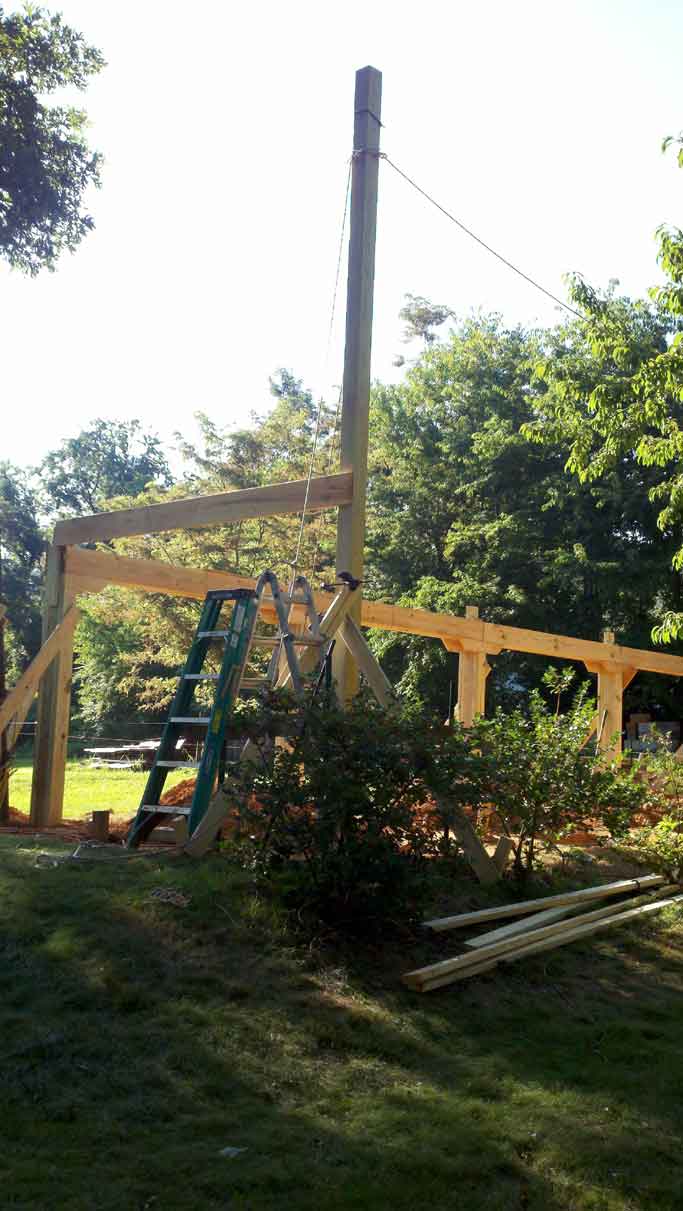

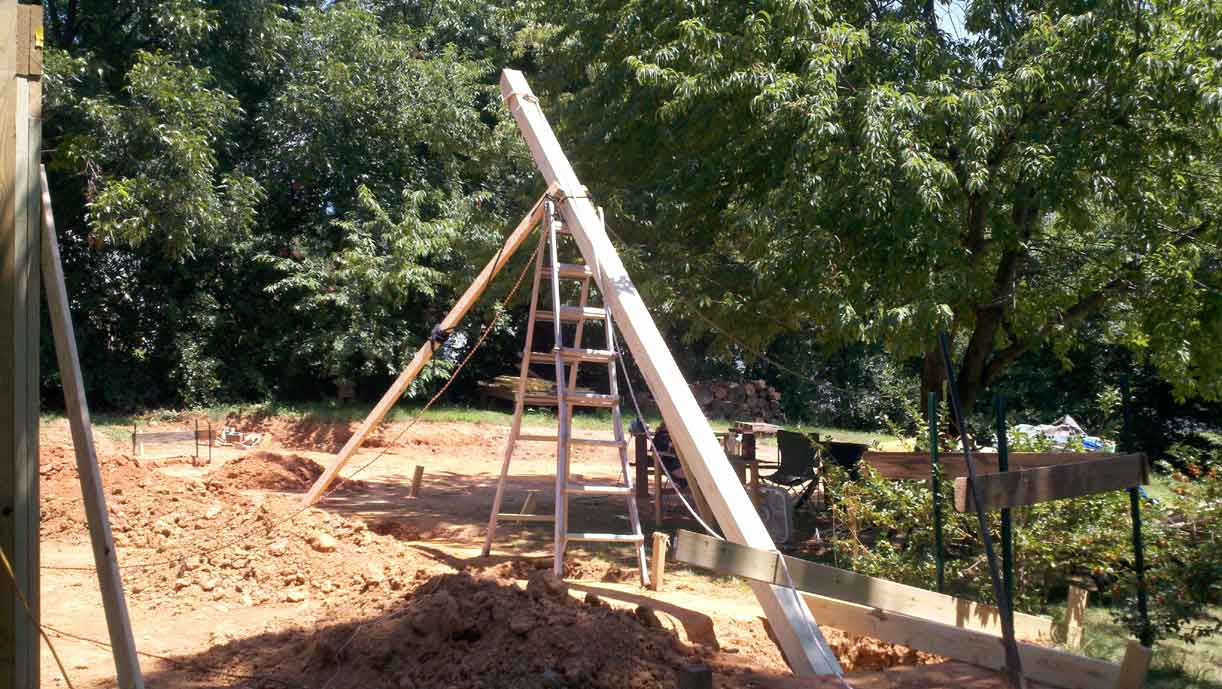

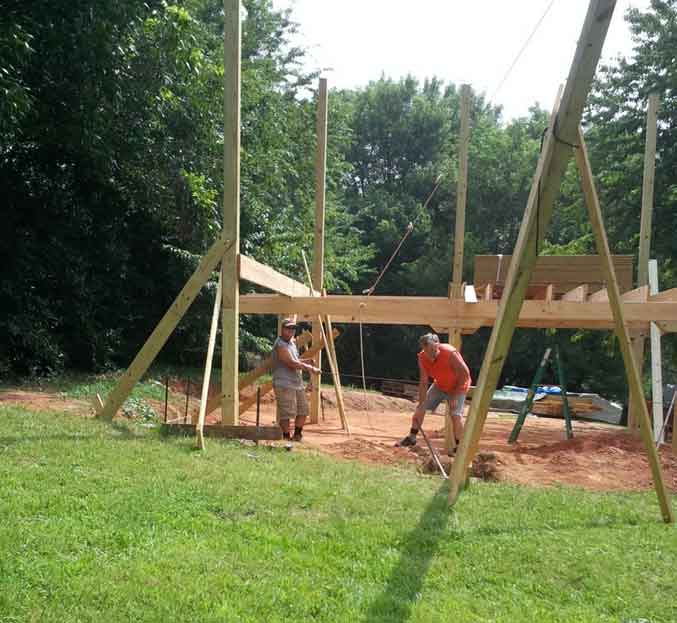

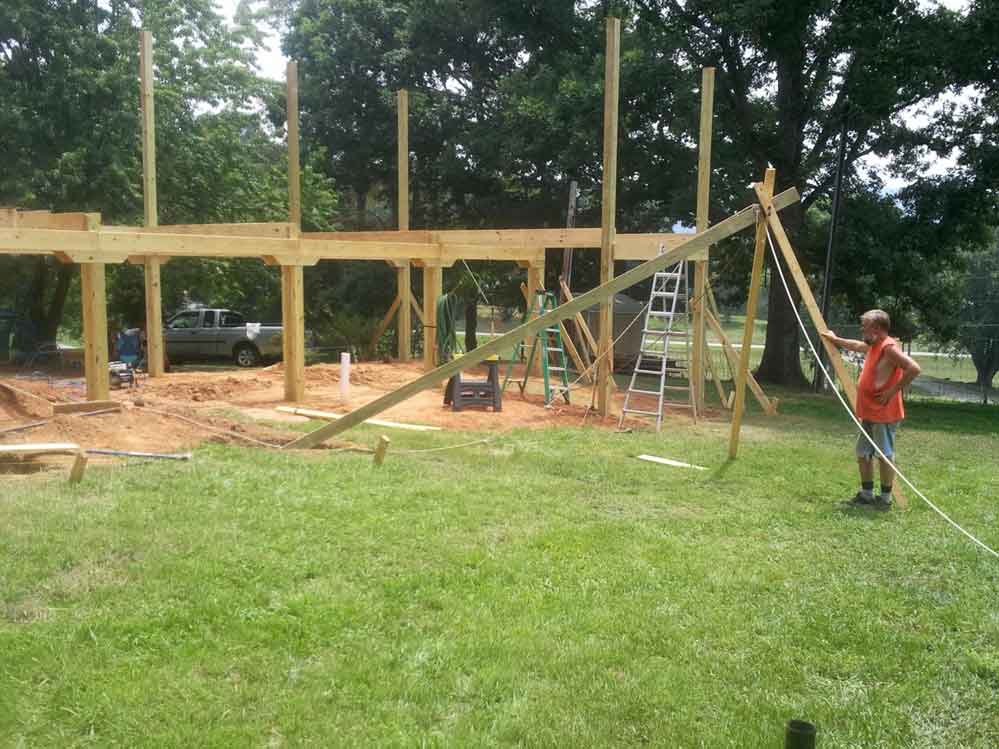

7/27/11 - This was our 1st 20' pole to get
vertical and standing on open concrete pad. We spent entire
day trying different methods, dropping the pole 3 times.
Finally with ropes and come-a-long we got her vertical. After
we had a system it took us about 1 hour to get a pole up and
plumbed. |

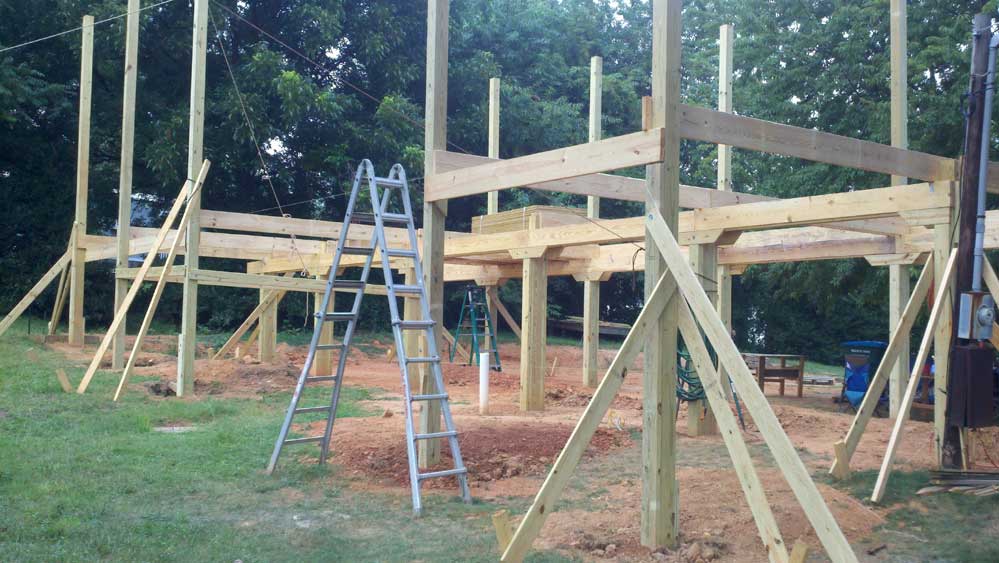

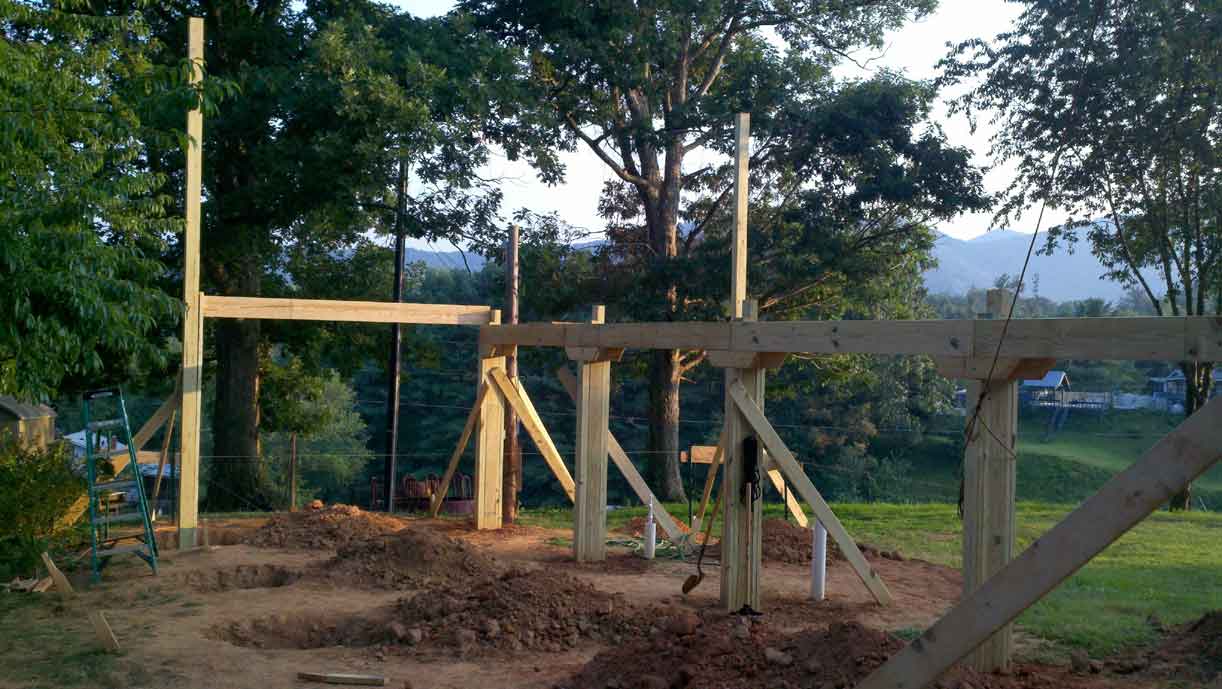

1st pole tied into center line with 1st floor joist. |
|

Poles going up and floor framing started |

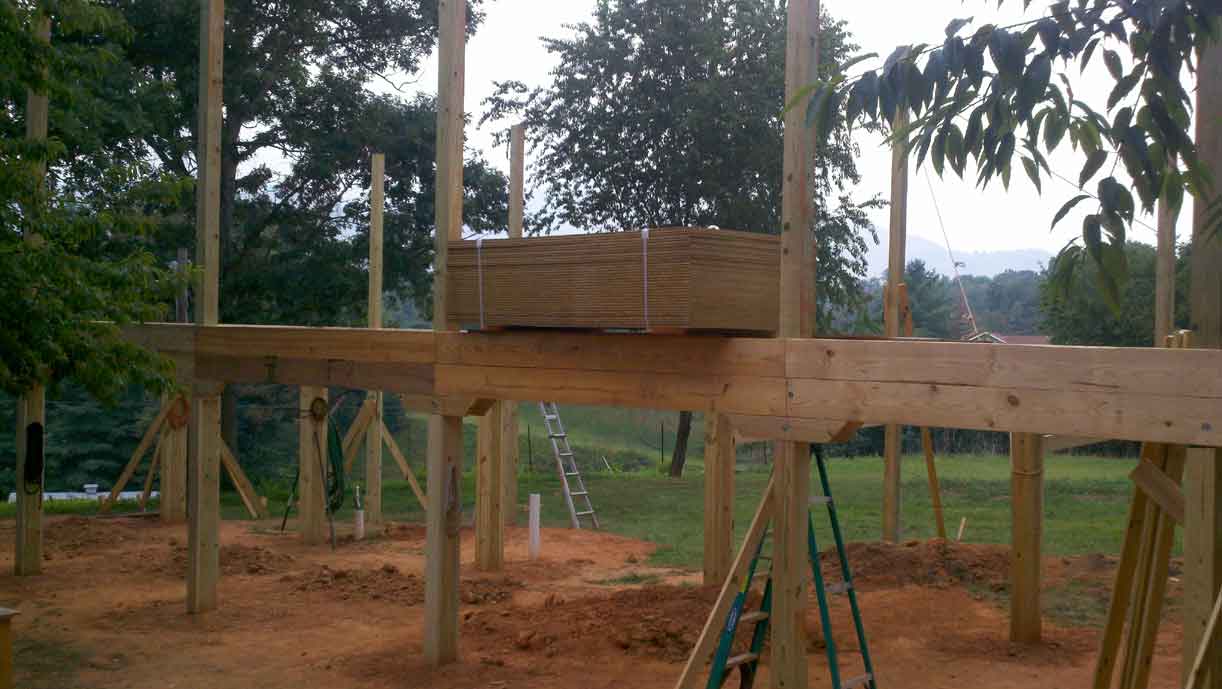

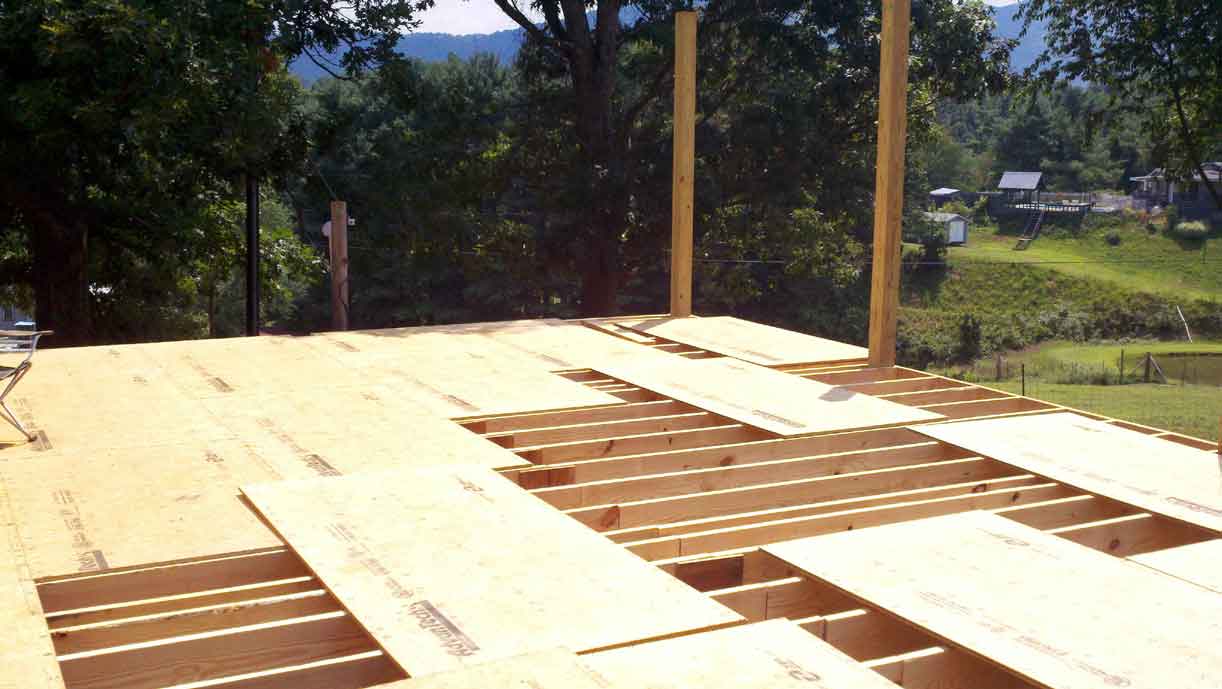

2800 lbs pile of subflooring
sent on house by fork lift, we were happy to see that house
did not fall down. 2nd pic of sub floor installation |
|

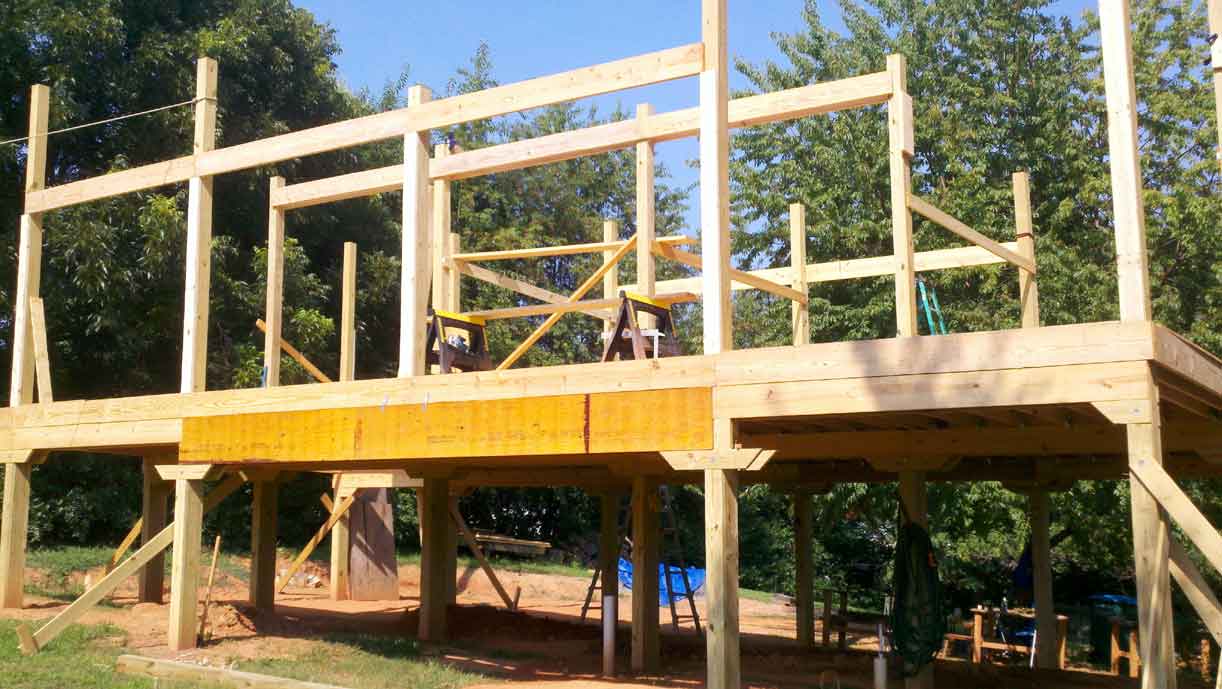

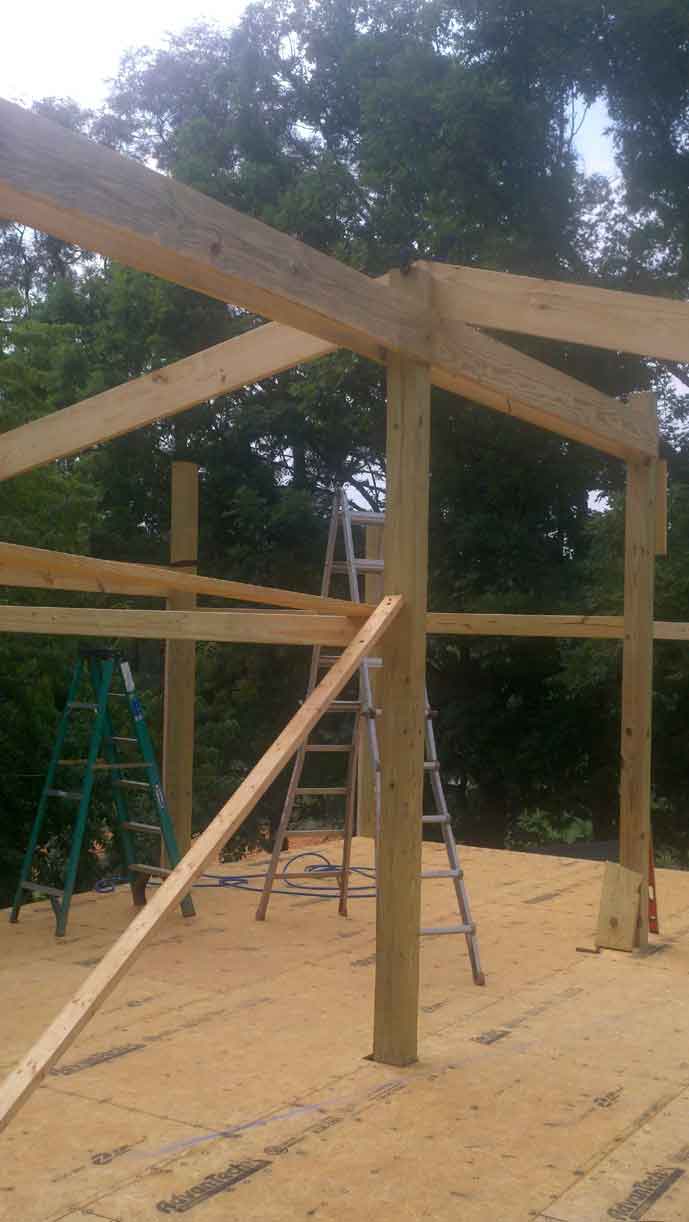

Upper girts started for roof joist support |

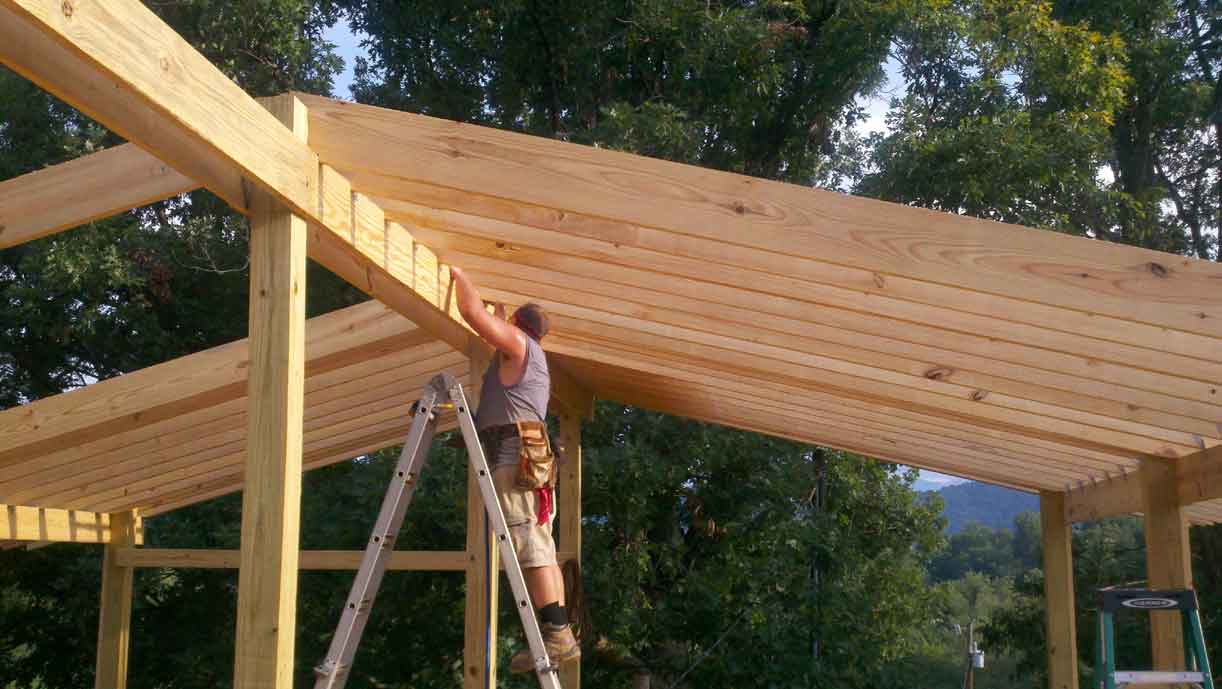

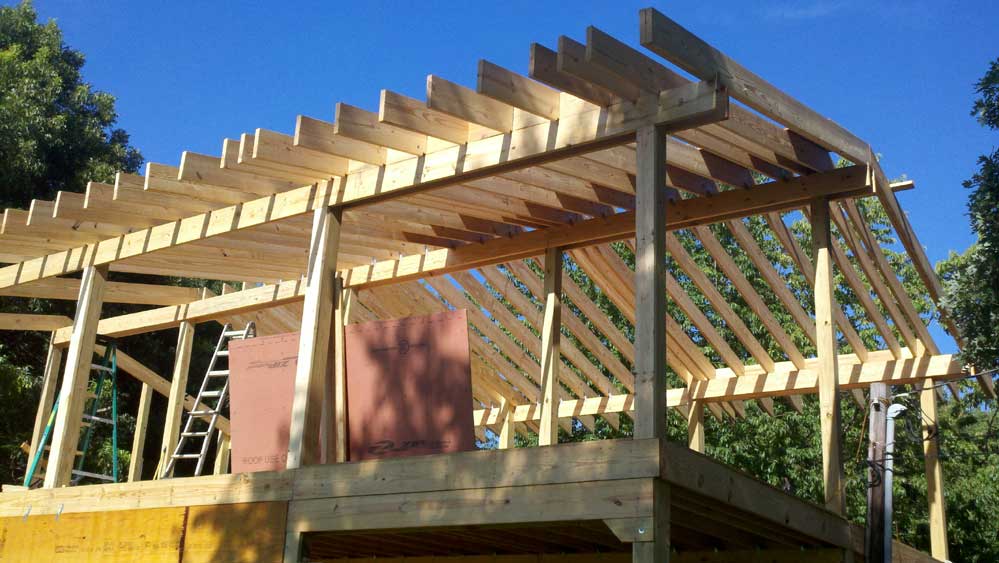

Rafters - 102 16'
2x10 rafters, Carl and I were glad when the last one was in
place |
|

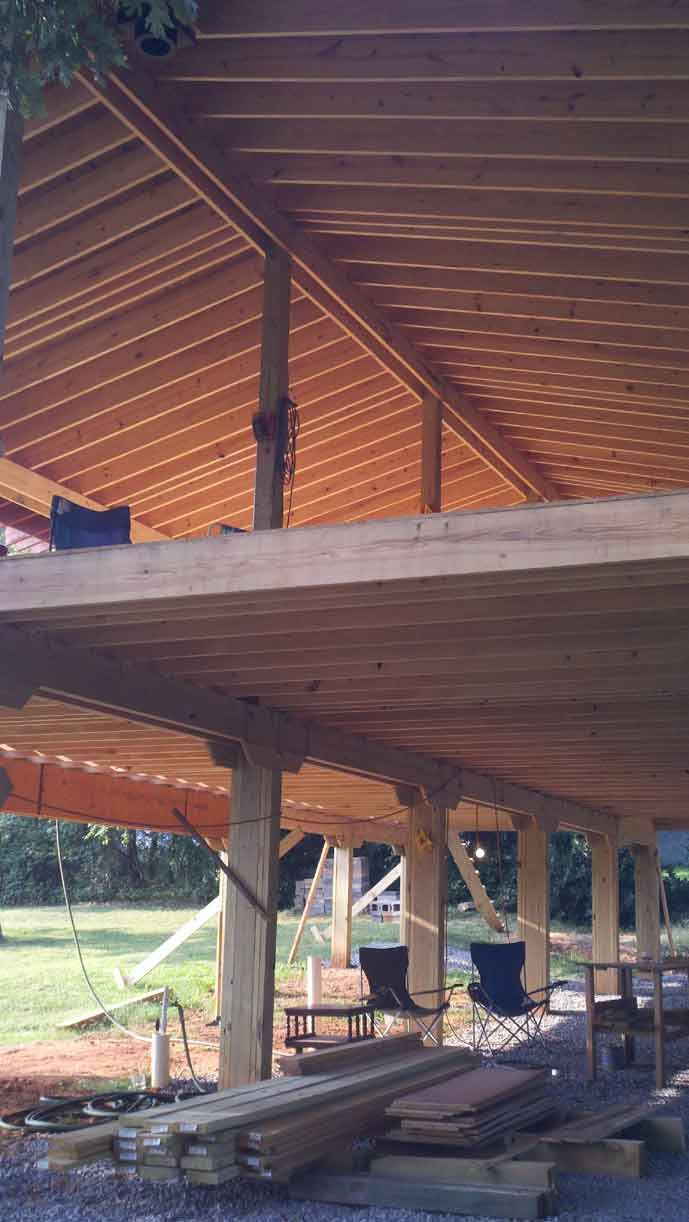

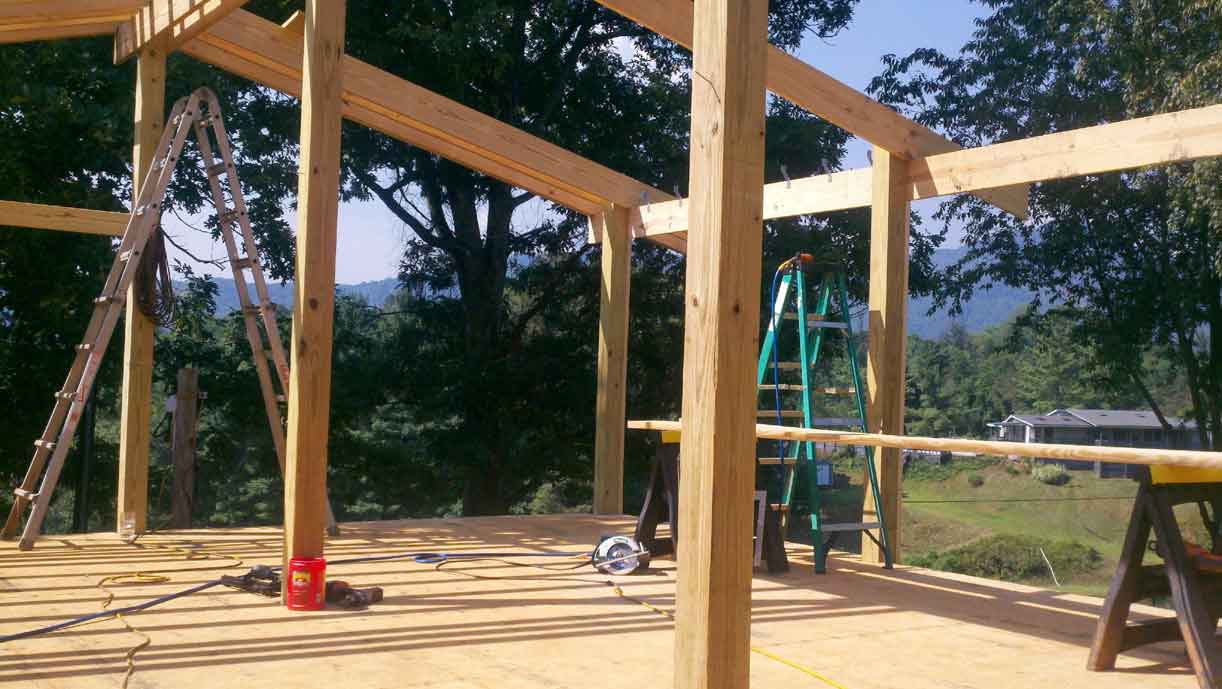

Rafters nearing completion |

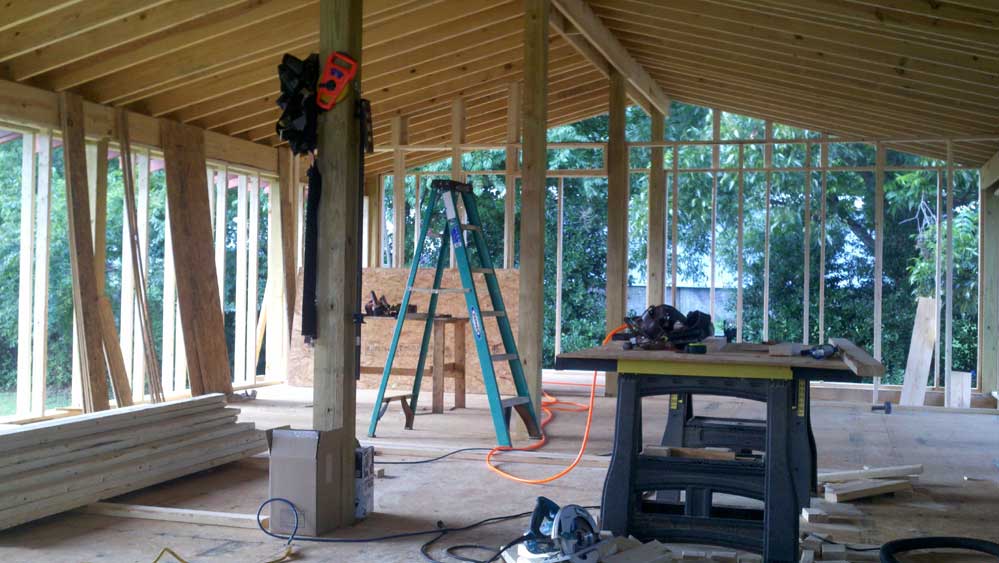

Beginning to frame the walls |
|

Note double wall detail is open at top to roof
joist cavity and is also open at bottom to floor cavity allowing
continues thermal barrier with little thermal breaks |

Double
walls framed and LVL beam in place We had to span 20
feet and skip a pole because of location of septic |
|

Break Time, we now have water proof
roof to keep rain and sun off our work |

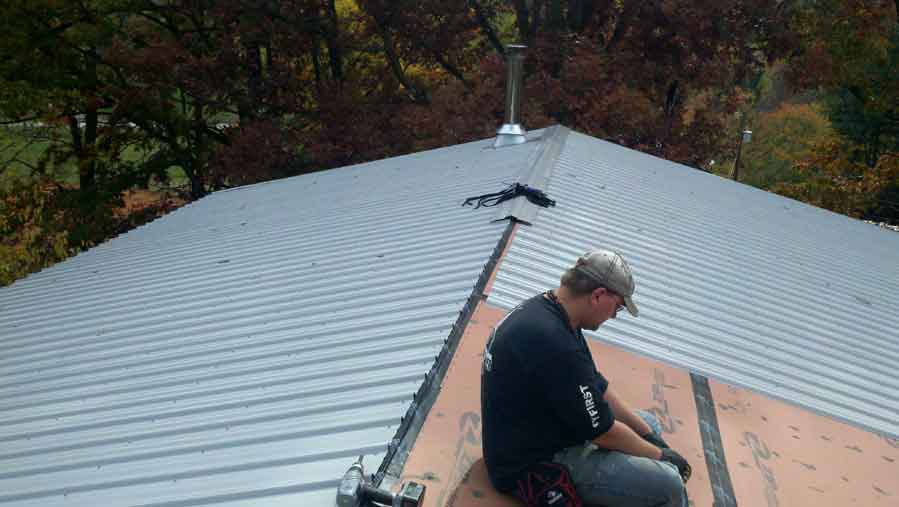

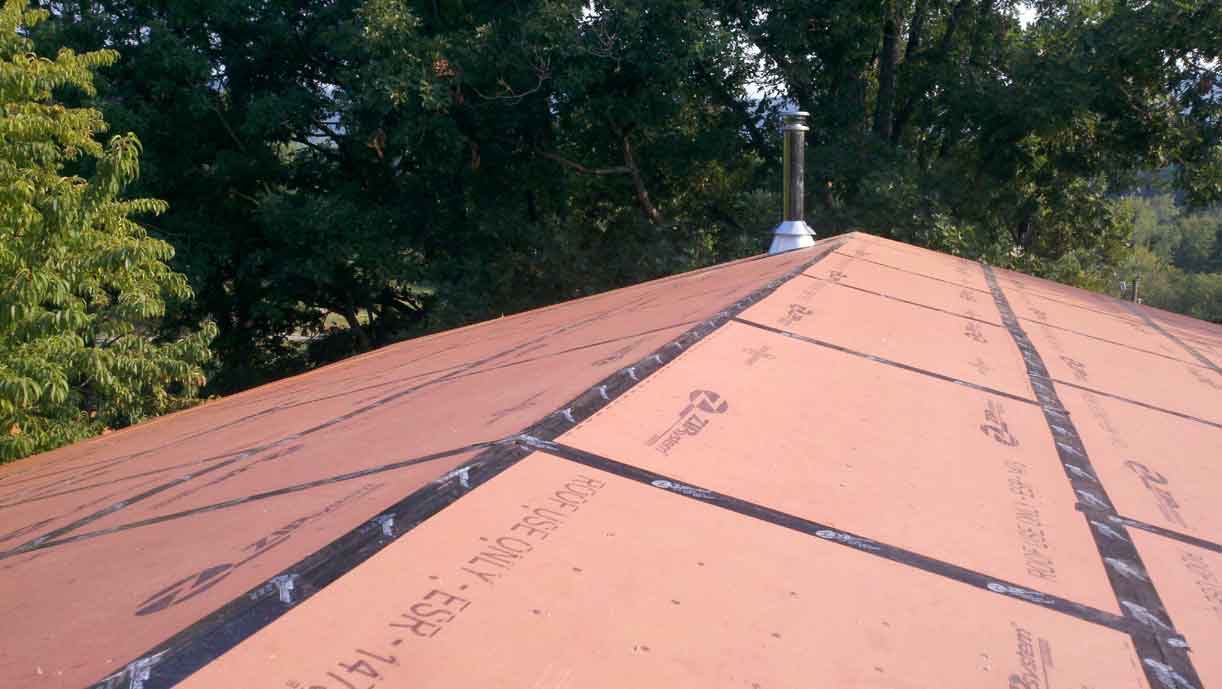

Zip system roof deck complete along
with installation of chimney for Jotel woodstove |
|

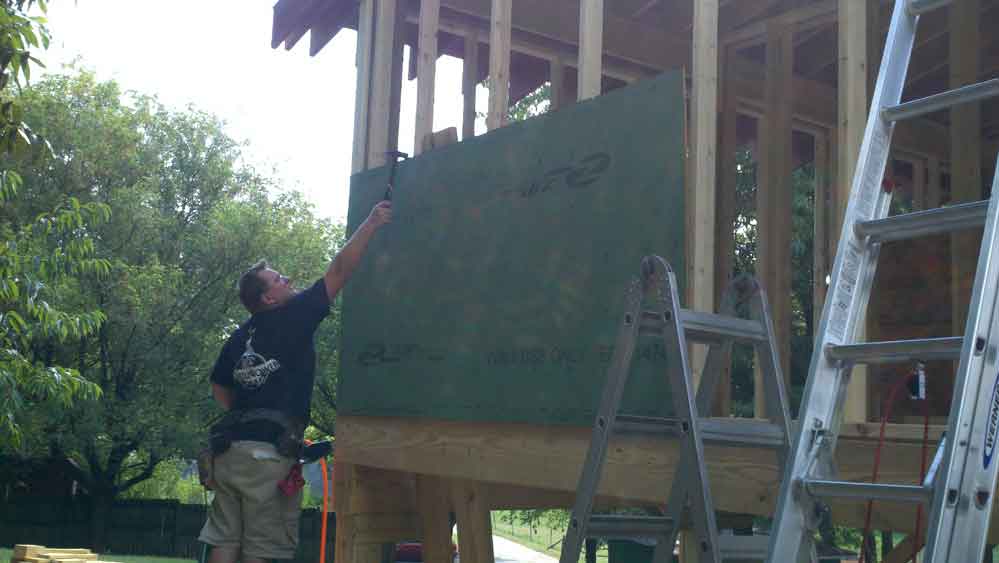

Start of wall sheathing, we used the
ZIP system which gives us an airtight and water proof wall
system |

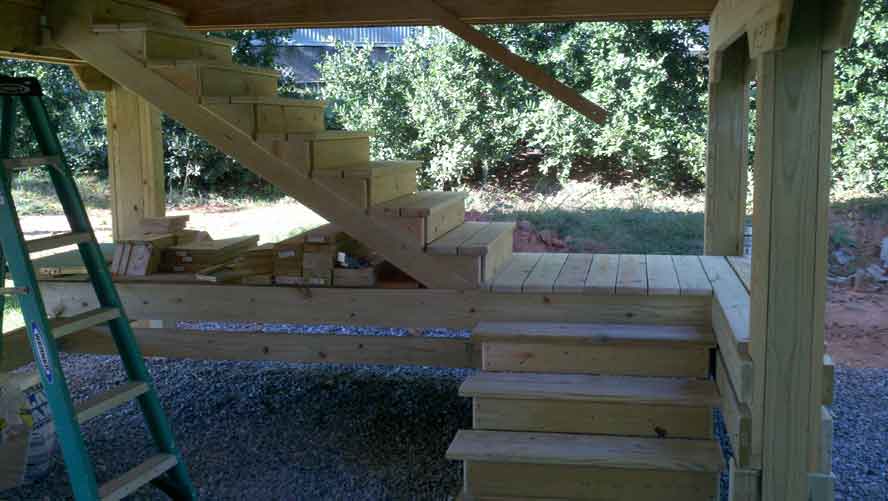

Stairs from our car parking area up to
house. They actually passed code inspection the first
time around |
|

Start of our metal roof.
Installation was fairly easy being that Carl and I had never
done a metal roof |

We got a pine french door to go in
right opening. Found pine door slabs to match as
windows and got an Amish company to make the munion bars. |
|

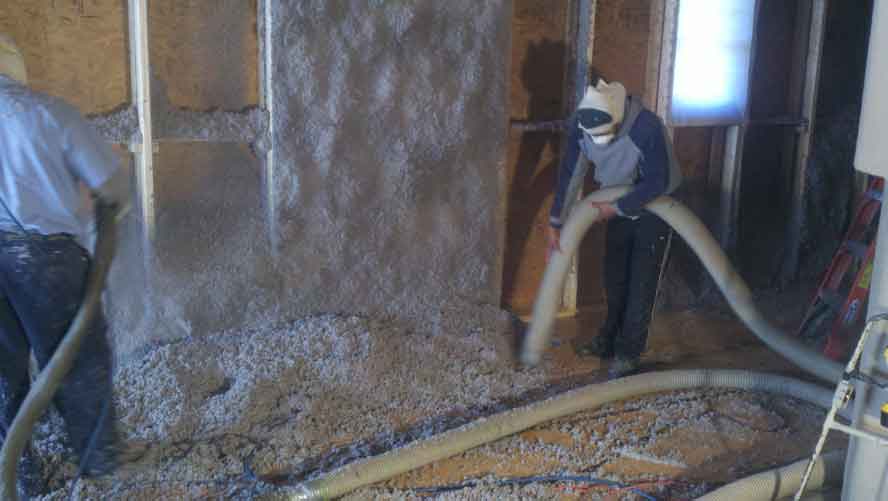

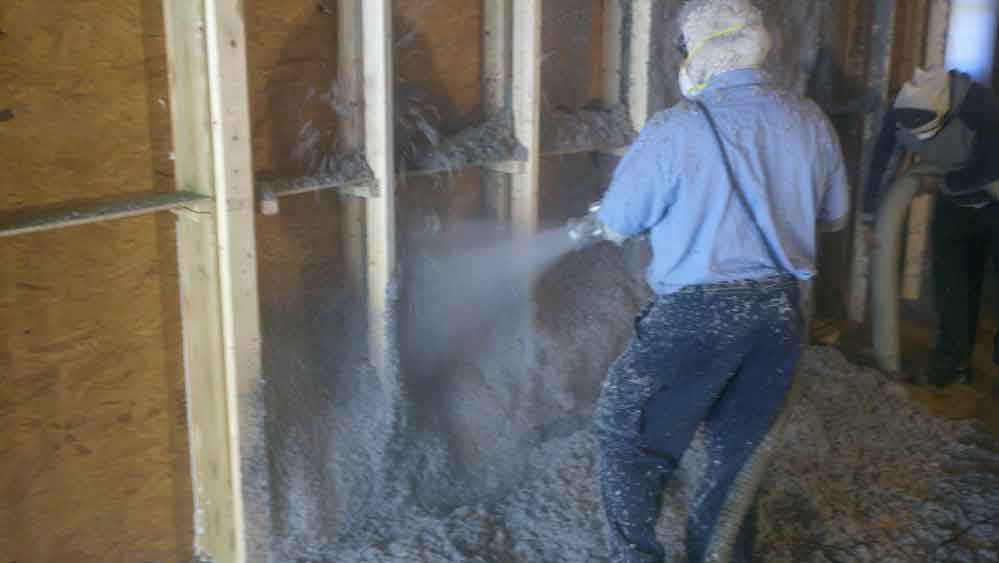

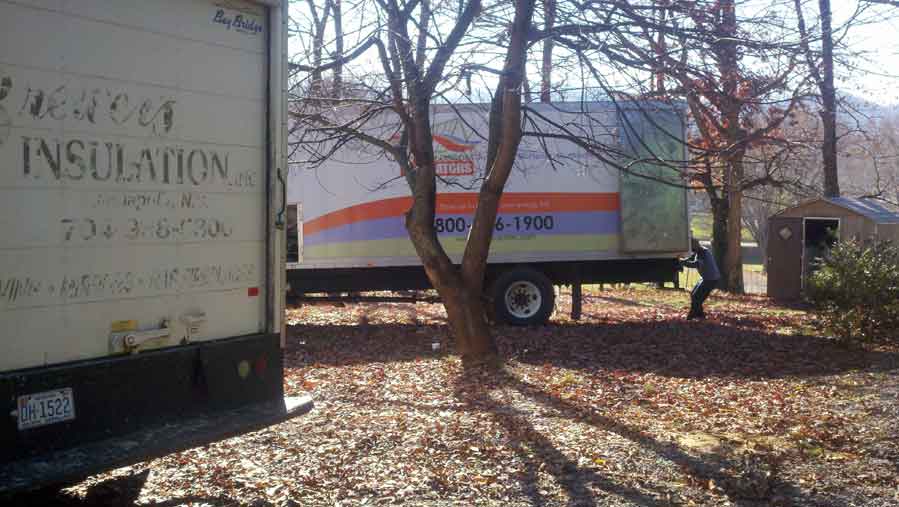

AppleBlossoms staff member (Eddie)
damp
spraying 10' walls with cellulose |

Walls blown and trimmed off to studs |
|
|

Purchased the D and the E ring for my

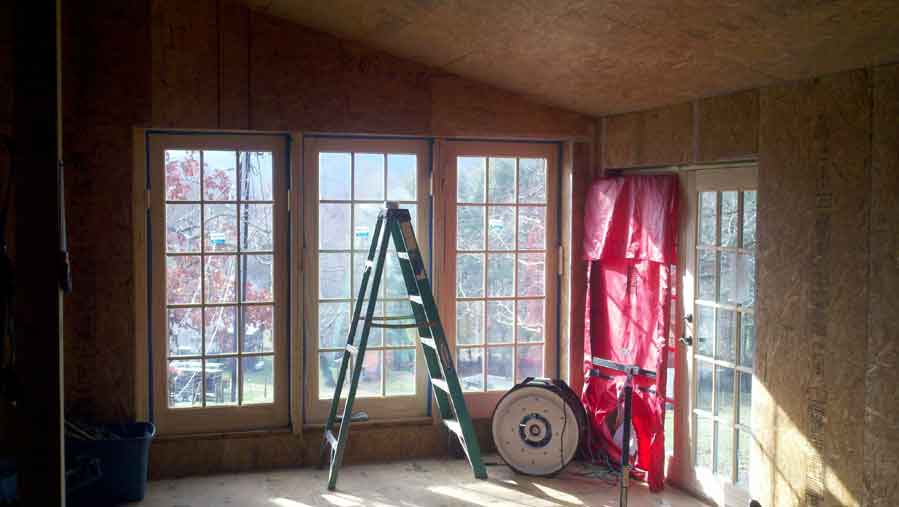

blower door. We are now able to get a reading with the
D ring, not sure if I will get to the E ring |
|

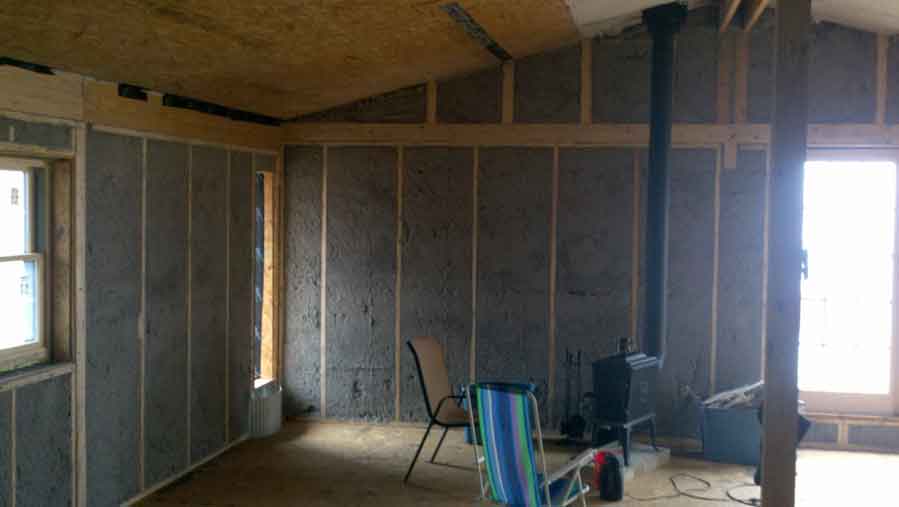

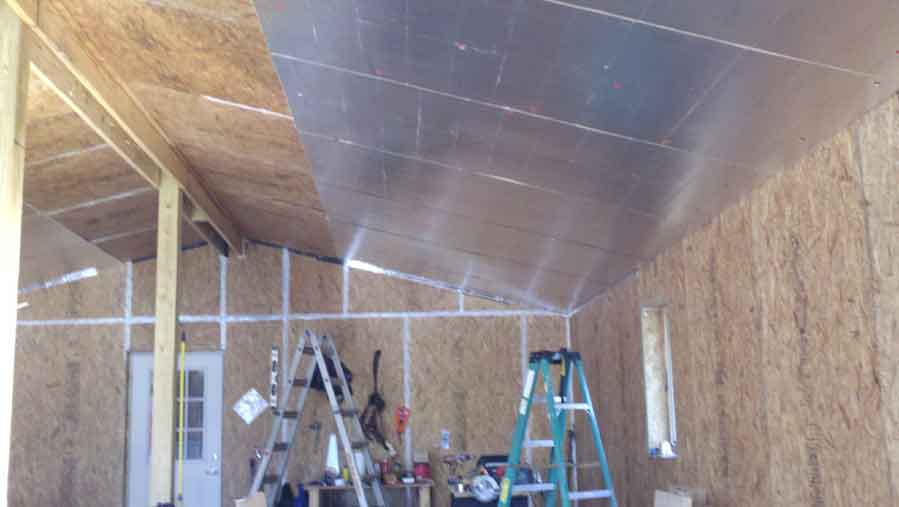

Ridged insulation going up over OSB
interior air barrier |

Kitchen getting started, we got a
close out at Ikea and got kitchen for $1800. Second
Pic is with corrugated metal wall installed. |
|

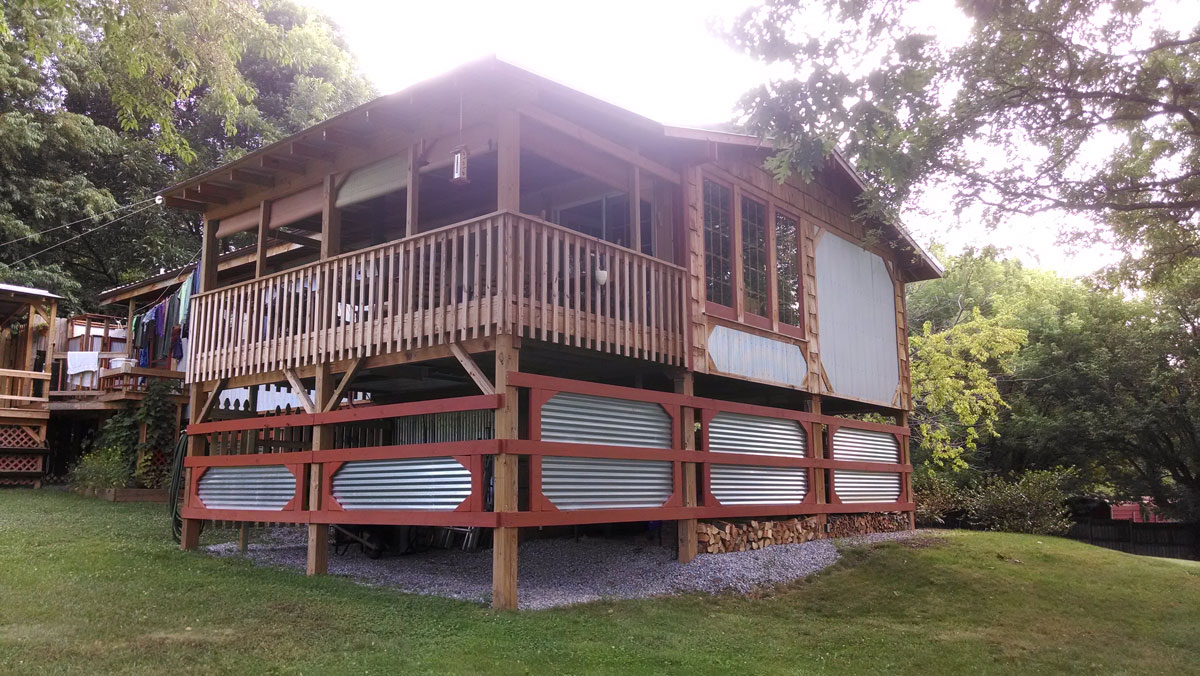

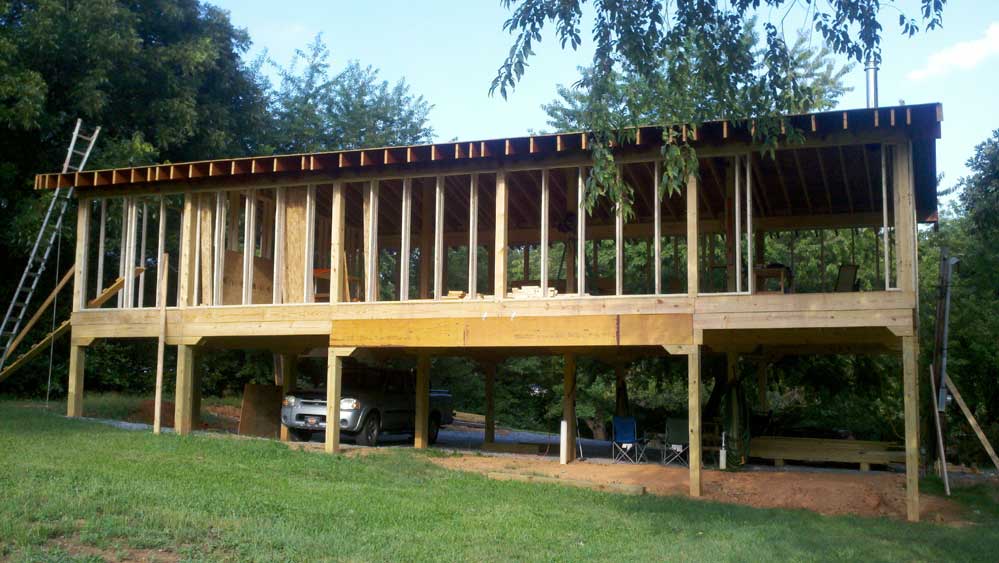

Cill and I day first pole went up on
7/22, House up, roof on, insulated, and
windows and doors in by Nov or 4 months later, Carl took the
pictures |
